Locomotive Works News

LSWR B4 No. 96 'Normandy'
2024 overhaul

Normandy's overhaul has started - Richard Salmon - 29 June 2024

'Normandy' in Atlantic House, its overhaul having commenced in mid-2024

The locomotive is in 'Atlantic House' for an "internal contract" overhaul, largely funded from the money already raised, with the work undertaken by the team who have built the new Brighton Atlantic.

In addition to this page, recording the overhaul for posterity, there are more frequent and detailed reports:

Normandy's frames now cleaned, needle gunned and in primer - Autumn 2025
Autumn 2025

A large update is available to download as a PDF.

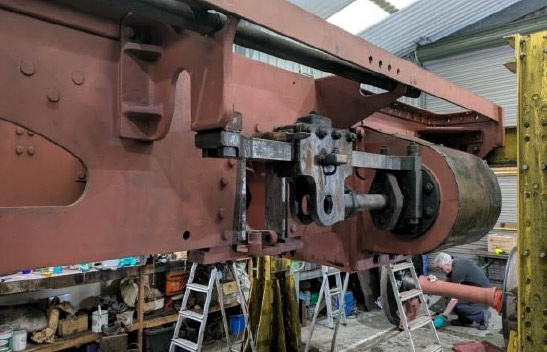

This photo shows Normandy's frames now lifted from its wheels, cleaned, needle gunned and in primer.

Autumn 2025 Report (PDF)

8 July 2025

The frames were lifted from the wheel sets on Tuesday 8th July using the jacking system in the Atlantic House. (Photo thanks to and © John Fry)

96 Chassis

The lifting beam being attached to the front buffer beam.

96 Chassis

At the back the lifting beam was positioned under the frames.

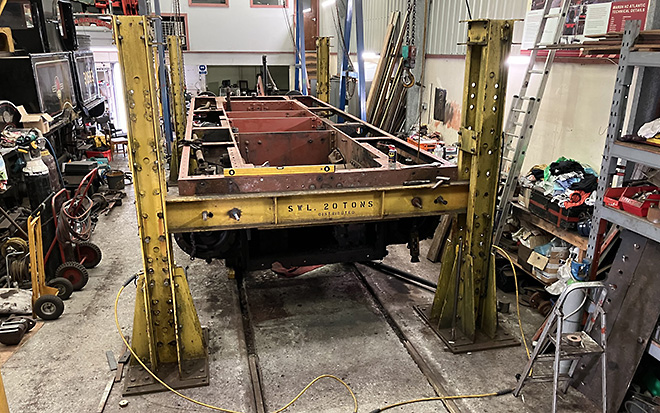

96 Chassis

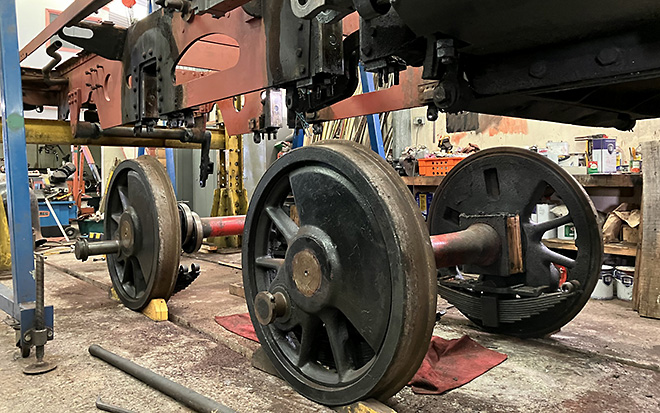

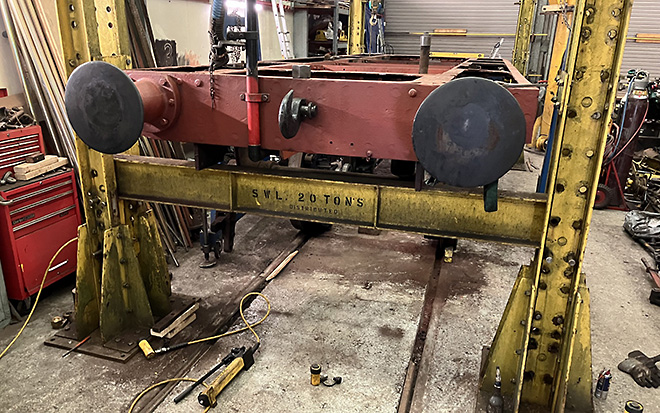

The frames lifted with the wheels ready to be rolled out.

96 Valve Chests

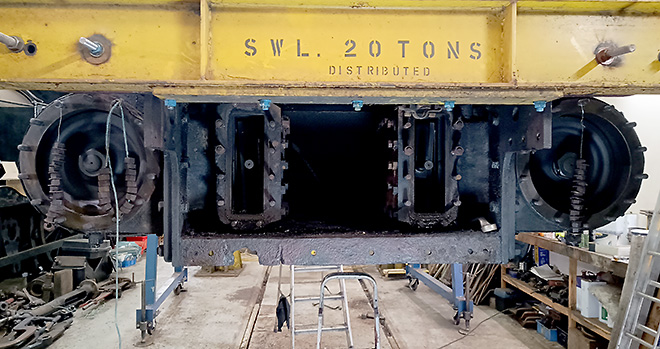

Cylinders and valve chest.

96 Chassis

The wheel sets after cleaning.

96 Chassis

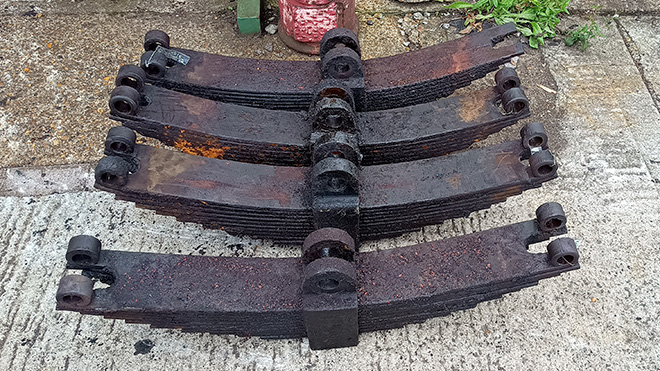

The four main springs including, at the back, one broken one.

96 Chassis

The brake blocks which need replacement!

96 Chassis

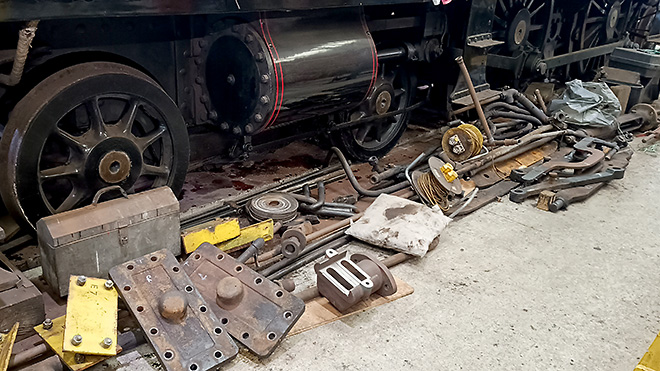

Some of the numerous items removed can be seen adjacent to the Adams Radial.

2 July 2025

The chassis has been cleaned and primed with areas due for further work noted.

New plate has arrived for the cab floor and the motion is being cleaned and inspected.

(Photo thanks to and © John Fry)

96 Chassis

The chassis with primer applied.

96 Cab Pates

Cab Floor Plates.

96 Weighshaft

The weighshaft.

96 Motion

The motion being worked on.

96 Eccentrics96 Eccentric

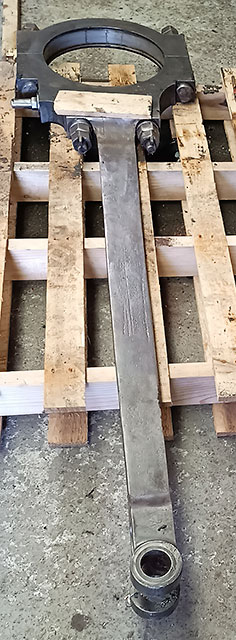

The eccentrics – before and after!

Normandy's boiler lift - Melvin Frohnsdorff - 10 April 2025
April 2025

On 10 April, as seen in Melvin Frohnsdorff's photo, Normandy was wheeled out of Atlantic House, and its boiler lifted.

Dismantling the locomotive, including lifting out the boiler, is always a key stage in any overhaul; the boiler can now be properly inspected to determine what repairs, beyond the mandatory replacement of boiler tubes, will be required.

Richard Salmon's photos below, taken on 21 and 27 April, show the frames in Atlantic House, and the boiler in the yard on its trolley.

Normandy's frames - Richard Salmon - 21 April 2025Normandy's boiler - Richard Salmon - 27 April 2025

See the Bluebell Railway's Web Page for 'Normandy' and the Bulleid Society's Web Page.

In addition to this page there are more frequent and detailed reports of the current overhaul:

splash The Queen's Award for Voluntary Service
Return to BRPS Home Page, to the Timetable or to Special Events
Locos Intro - Operational Locos - Locos under overhaul - Locos on static display - Locos formerly based on the Bluebell
Loco Roster - Loco Stock List - Loco Works News - Join the Loco Dept

Visitor Info. - Museum - Trust - Catering - Contacts - What's New - Projects - Locos - Carriages & Wagons - Signals - History - Other - Links - Search - FAQ
Why not become a BRPS Member?     -     Get more involved as a Volunteer

Your ideal Film/TV location?

Valid HTML 4.0 Transitional! Last update 3 February 2026 by Richard Salmon.
© Copyright BRPS.             Privacy Policy
